Dogfish Creek Estuary Bridge
|
Poulsbo City of; Dogfish Creek Estuary Bridge (#00-1720)
05/16/2002, Attachment #2771, Outlet2
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
The City of Poulsbo will restore habitat and ecological functions to the upper Liberty Bay/Dogfish Creek estuary by removing the culvert that blocks saltwater exchange over 4 acres of tidelands. This shoreline/tideland complex is listed as critical habitat by NMFS to the recovery of Puget Sound chinook. The benefits gained from this project include recovery of the intertidal marine algaes, epibenthic production of primary juvenile salmon food items including copepods and amphipods and other invertebrates, and enhancement of associated habitat attributes. Dogfish Creek has runs of chinook, coho, and chum salmon and steelhead and cutthroat trout that will benefit form this project. This bridge project will tie into City Parks Department's passive use/salmon education trail and riparian property acquisition to protect and restore Dogfish Creek's salmon runs.
|

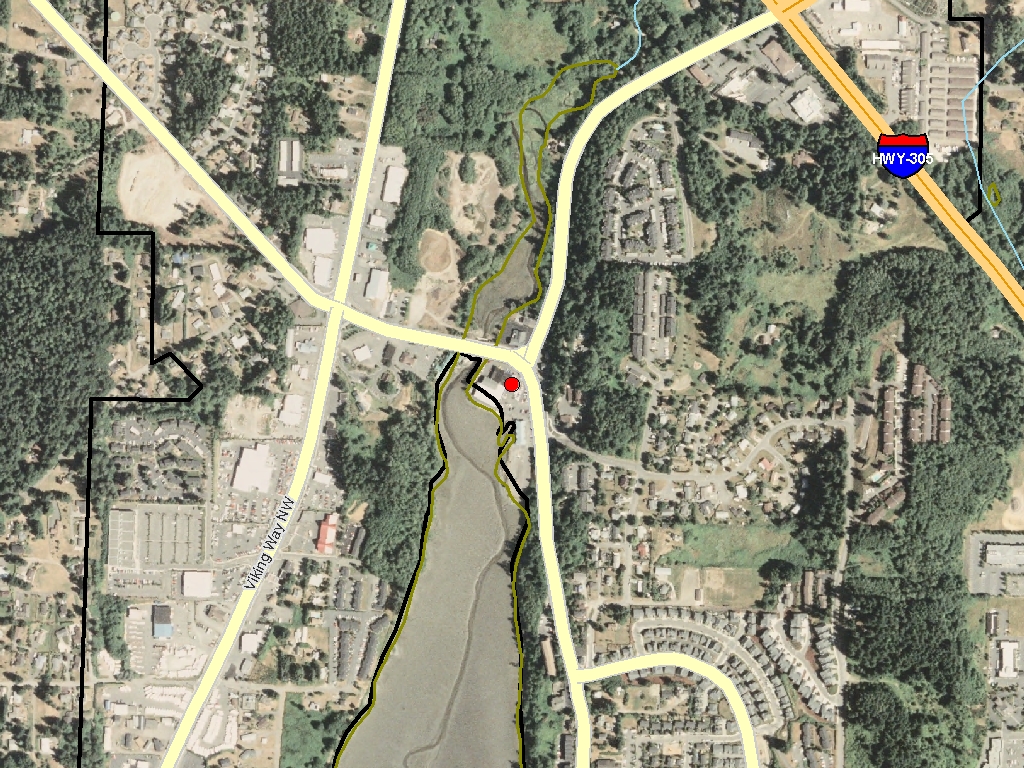

General Area:
|
|
North end of Liberty Bay within the City of Poulsbo.
|
County:
|
|
Kitsap
|
Legislative District:
|
|
23
|
Congressional District 2022:
|
|
06
|
Salmon Recovery Regions:
|
|
Puget Sound
|
Watershed Administrative Unit:
|
|
Liberty-Miller-Appletree
|
HUC8:
|
|
Puget Sound (17110019)
|
WRIA:
|
|
Kitsap
|
Sections:
|
|
15
|
Township:
|
|
T26NR01E
|
Coordinates:
|
|
47.74639437 -122.65118847
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Dogfish Creek Estuary Bridge (#1)
|
Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Fish passage blockages removed or altered (C.2.c.1)
|
$1,602,511
|
| Total | $1,602,511 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Dogfish Creek Estuary Bridge (#1)
|
|
Property 1 - Property - Worksite #1
|
Local Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Fish Passage Improvement |
Fish passage blockages removed or altered (C.2.c.1) |
|
Number of Blockages/Impediments/Barriers Removed/Altered (C.2.c.2)
|
1
|
Bridge installed or improved (C.2.g.1) |
|
Miles of stream made accessible by bridge installation/repair (C.2.g.3)
|
6.00
|
|
Number of bridges (C.2.g.2)
|
1
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
1
|
Milestone Name | Target Date | Description |
Project Start
|
02/14/2001
|
Consultant selection started
|
RFP Complete
|
03/15/2001
|
Complete consultant selection
|
Applied for Permits
|
06/15/2001
|
HPA, Shoreline, COE-BA
|
A&E Plans Submitted
|
02/10/2003
|
PS&E Completed
|
Bid Awarded/Consultant Hired
|
03/01/2003
|
Advertise & Award
|
Construction Started
|
04/01/2003
|
Notice to proceed
|
Construction Complete
|
10/31/2003
|
Substantial completion
|
Agreement End Date
|
06/30/2004
|
Final completion
|
Final Docs/Billing to Mgmt Agy
|
09/30/2004
|
Project closeout
|
