Project Snapshot
PRISM Project #05-1382 (Completed)
Robinson - WF Rocky Cr. R3
    Project Details
South Puget Sound SEG; Robinson - WF Rocky Cr. R3 (#05-1382)

Attachment #39455, Downstream 2
South Puget Sound SEG; Robinson - WF Rocky Cr. R3 (#05-1382) Attachment #39455, Downstream 2

South Puget Sound SEG; Robinson - WF Rocky Cr. R3 (#05-1382)

Attachment #39455, Downstream 2 South Puget Sound SEG; Robinson - WF Rocky Cr. R3 (#05-1382)

07/31/2000, Attachment #16456, RobinsonDSculv
Project Status:  Closed Completed since 05/22/2007

Project Type:  Restoration
Project Sponsor:  South Puget Sound Salmon Enhancement Group
Funding Board:  Recreation and Conservation Office
              Funding
FFFPP Grants: $27,752
Total RCO Grant: $27,752 (49%)
Sponsor Match: $28,939 (51%)
Total Agreement: $56,691 (100%)
              Links


    Project Description
Rocky Creek is one of the largest watersheds in WRIA 15. Rocky Creek is approximately five miles in length with an additional 10-12 miles of tributary length. Overall habitat characteristics are rated as good for Rocky Creek (May and Peterson, 2003.) The drainage is host to many wetland and lake complexes, which provide optimal rearing habitat for species such as coho, steelhead and cutthroat.



This project proposes the removal of a barrier culvert located on a private driveway and the West Fork of Rocky Creek (15.0021). The existing pipe is a round corrugated steel pipe 0.9 meter diameter, outfall 0.2 meters, slope 1.8%, velocity 1.1 feet per second (7/31/2000). A 'Level A' assessment was used to determine barrier status. The culvert is crushed on the downstream side and rusted throughout the interior. The high velocities that occur during peak migration periods and outfall drop result in a severe impediment to fish migration.



"There is 10,500 feet of extremely good habitat downstream of this culvert (144th Street), and 7,900 feet of good and 700 feet of fair habitat upstream of this culvert on the main stem of Rocky, along with additional good (2,000'), fair (2,300'), and poor (800') habitat on the western tributary of Rocky upstream of this culvert" (Jennifer Belknap, URS, DRAFT KGI Basin Plan, 2004).



Rocky Creek supports Chinook, coho, chum, cutthroat and steelhead trout.


    Project Contacts

Project Sponsor: South Puget Sound Salmon Enhancement Group Lead Entity: West Sound Partners for Ecosystem Recovery
  Project Contact: Kristin Williamson
kristinw@spsseg.org
(360) 561-1715


Funding Agency: Recreation and Conservation Office
  Project Manager: Sandy Dotts
sandra.dotts@rco.wa.gov
(360) 628-9487

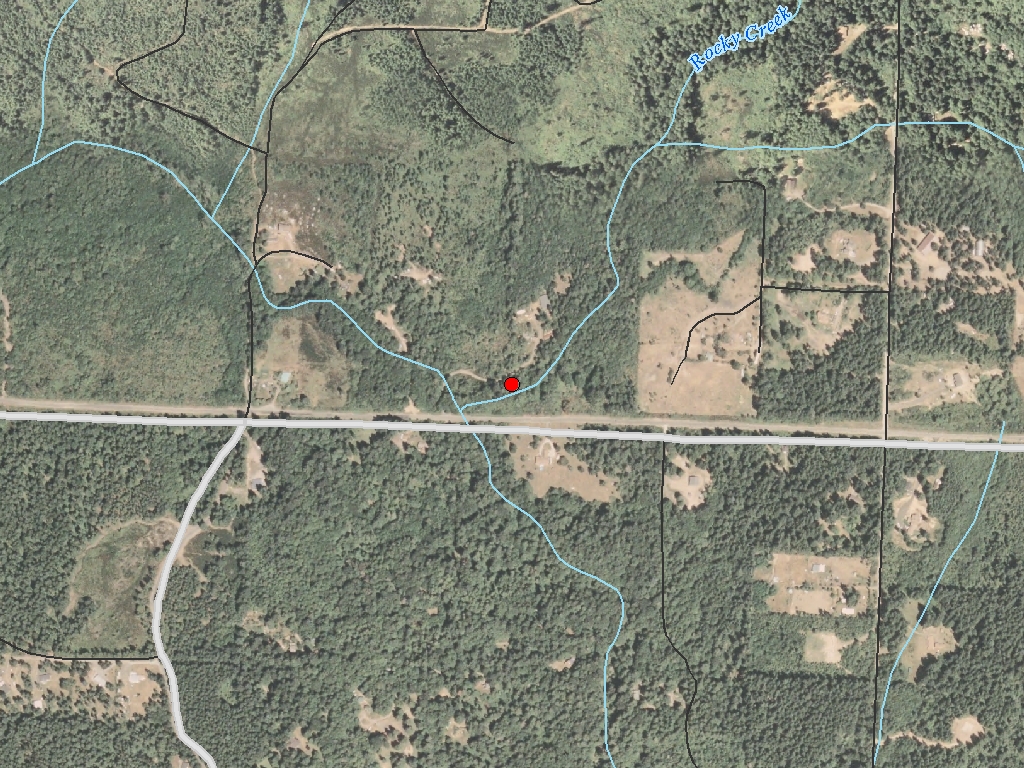

    Project Location
General Area:   Key Pen.
Waterbody:   Rocky Creek, Unnamed
County:   Pierce
Legislative District:   26
Congressional District 2022:   06
Salmon Recovery Regions:   Puget Sound
Watershed Administrative Unit:   Key Peninsula
HUC8:   Puget Sound (17110019)
WRIA:   Kitsap
Sections:   15
Township:   T22NR01W
Coordinates:   47.38949485
-122.78506849

    Worksites
Worksite NameScope of WorkActual Restoration Cost
Robinson (#1) Architectural & Engineering (A&E), Culvert installed or improved (C.2.f.1), Fish passage blockages removed or altered (C.2.c.1), Road-crossing removal (C.2.i.1), Utility relocation / reconnection $7,809
 Total$7,809
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Robinson (#1)   Property 1 - Property - Worksite #1 Private
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricFinal

Restoration Metrics (rolled up from Worksite level)

Fish Passage Improvement
      Fish passage blockages removed or altered (C.2.c.1)
Number of Blockages/Impediments/Barriers Removed/Altered (C.2.c.2) 1
      Culvert installed or improved (C.2.f.1)
Miles of stream made accessible by culvert installation/repair (C.2.f.3) 3.47

Number of blockages / impediments / barriers impeding passage (C.2.b.4) 1

    Project Permits
Permit TypeApplied
Date
Received
Date
Expiration
Date
Permit Number
Endangered Species Act Compliance [ESA]
Hydraulics Project Approval [HPA]

    Project Milestones
Milestone NameTarget DateDescription
Project Start 10/31/2005
30% Design Review/Cost Check 11/30/2005
Applied for Permits 12/30/2005
Bid Awarded/Contractor Hired 05/01/2006
Construction Started 07/01/2006
Construction Complete 09/15/2006
Agreement End Date 12/31/2006
Final Docs/Billing to Mgmt Agy 02/01/2007


    Project Attachments
Attachment TypeAttachment TitleAttach Date
Agreement - State 05-1382 FFFPP Agreement - 6 pgs..pdf 03/15/2008
Barrier evaluation form 05-1382 RobinsonBEF- WFRocky(B).pdf 08/02/2005
Forest Landowner Application Tracking Form 05-1382 FFFPP initial tracking form.pdf 06/30/2005
Forest Landowner Welcome Letter 05-1382 FFFPP welcome letter .pdf 06/30/2005
Landowner acknowledgement form 05-1382 Acknowledgement form.pdf 10/24/2005
Landowner application 05-1382 Robinson directions.pdf 06/29/2005
Landowner application 05-1382 Robinson application.pdf 06/29/2005
Photo Robinson_Nov.jpg 11/14/2006
Photo Downstream 2.jpg 09/19/2006
Photo road.jpg 09/19/2006
Photo Upstream.jpg 09/19/2006
Photo Downstream from culvert.jpg 09/19/2006
Photo RobinsonDSculv.jpg 07/06/2005
Project plan document 05-1382 Johnson Hydraulic Project Approval hpa-preview[1].pdf 02/02/2009
Project plan document 05-1382 Huge Ck.W Fork Rocky Ck. Preliminary Design Report.pdf 05/26/2006
Site map WDFW 05-1382 Robinson site map.pdf 07/06/2005
Watershed map WDFW 05-1382 Robinson wau map.pdf 07/06/2005
