Beaver Creek Estuary Restoration - 2005
|
Mid-Puget Sound Fish Enh Grp; Beaver Creek Estuary Restoration - 2005 (#05-1437)
Attachment #45662, New Culvert-looking upstream from estuary
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
This project is a continuation of an ongoing stream ecosystem restoration project for the lower reaches of Beaver Creek, near Manchester. The project area is on US Navy property at the Fleet Industrial Supply Center, Manchester Fuel Depot (MFD). In 2003 MFD completed the first phase of an extensive fish passage and habitat enhancement project for Beaver Creek as it runs through their property, referred to as Phase 1 of Beaver Creek Restoration. MFD completed the design work for Phase 2 of the restoration in January 2004 and began construction during the summer of 2004. Phase 2 goals are to provide natural stream meanders for the lower reaches of Beaver Creek based upon extensive analysis of the hydrology, geomorphology, topography, and historic condition of the Beaver Creek system. Additional funding is being sought for a third phase that would extend the restoration work to the estuary at Clam Bay. This project has been developed through cooperative efforts between the US Navy, the Suquamish Tribe, and the Mid-Puget Sound Fisheries Enhancement Group. Specifically, Phase 3 will involve upgrading a temporary culvert to a full span opening, removing the outlet fish ladder, reconstructing the greater estuarine habitat, and reestablishing the saltwater wedge into the historic upper estuary location. The project would result in a net gain of approximately 4.5 acres of estuary and riparian habitat and 1,200 feet of shoreline - both of which are vital resources for the area's threatened and endangered salmon species.
|

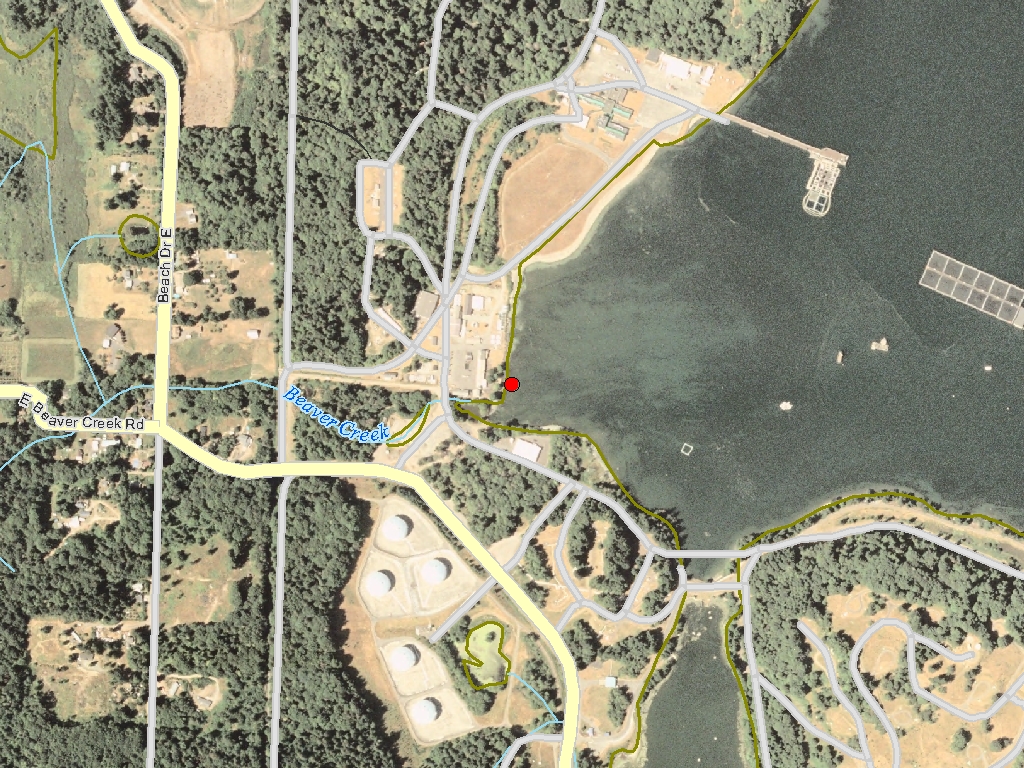

General Area:
|
|
Beaver Creek estuary project site is adjacent to the NOAA Fisheries Research Facility and the Manchester Labs on the Manchester Fuel Depot property.
|
Waterbody:
|
|
Beaver Creek
|
County:
|
|
Kitsap
|
Legislative District:
|
|
26
|
Congressional District 2022:
|
|
06
|
Salmon Recovery Regions:
|
|
Puget Sound
|
Watershed Administrative Unit:
|
|
Clovos Passage/Carr Inlet
|
HUC8:
|
|
Puget Sound (17110019)
|
WRIA:
|
|
Kitsap
|
Coordinates:
|
|
47.57031555 -122.55147982
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Beaver Creek Estuary (#1)
|
Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Channel structure placement (C.4.d.1), Creation of new estuarine area (C.9.q.1), Estuarine plant removal / control (C.9.j.1), Fish passage blockages removed or altered (C.2.c.1), Planting (C.5.c.1), Regrading of slope (C.9.i.1), Utility relocation / reconnection
|
$700,217
|
| Total | $700,217 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Beaver Creek Estuary (#1)
|
|
Property 1 - Property - Worksite #1
|
Federal Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Fish Passage Improvement |
Fish passage blockages removed or altered (C.2.c.1) |
|
Number of Blockages/Impediments/Barriers Removed/Altered (C.2.c.2)
|
1
|
Instream Habitat Project |
Channel structure placement (C.4.d.1) |
|
Miles of Stream Treated for channel structure placement (C.4.d.3)
|
0.25
|
|
Acres Of Streambed Treated for channel structure placement (C.4.d.4)
|
0.2
|
|
Pools Created through channel structure placement (C.4.d.5)
|
6
|
|
Number of structures placed in channel (C.4.d.7)
|
6
|
Riparian Habitat Project |
Planting (C.5.c.1) |
|
Acres Planted in riparian (C.5.c.3)
|
1.5
|
Estuarine / Nearshore Project |
Regrading of slope (C.9.i.1) |
|
Acres of Estuary Treated through slope regrading (C.9.i.2)
|
3.3
|
Estuarine plant removal / control (C.9.j.1) |
|
Acres of Estuary Treated for plant removal/control (C.9.j.3)
|
3.3
|
Creation of new estuarine area (C.9.q.1) |
|
Acres of Estuary Created (C.9.q.2)
|
1.5
|
Fish Passage Improvement |
Bridge installed or improved (C.2.g.1) |
|
Miles of stream made accessible by bridge installation/repair (C.2.g.3)
|
0.25
|
|
Number of bridges (C.2.g.2)
|
1
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
1
|
Milestone Name | Target Date | Description |
Project Start
|
01/06/2006
|
|
Applied for Permits
|
01/31/2006
|
|
Monitor/Steward Plan Submitted
|
02/28/2006
|
|
Bid Awarded/Consultant Hired
|
03/15/2006
|
|
A&E Plans Submitted
|
05/15/2006
|
|
Construction Started
|
07/15/2006
|
|
Construction Complete
|
10/31/2006
|
|
Agreement End Date
|
12/30/2006
|
|
Final Docs/Billing to Mgmt Agy
|
03/31/2007
|
|
