Skykomish Braided Reach Restoration-Ph II
|
Snohomish County of; Skykomish Braided Reach Restoration-Ph II (#07-1709)
10/19/2011, Attachment #128178, apex jam
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
Limiting factors in the reach include flood and low flows, lack of refuge and rearing habitat, and lack of pool habitat. Rearing and refuge habitat have been diminished due to railroad and highway construction, which has reduced overall floodplain area. The proposed projects build on the SRFB funded Braided Reach Restoration Assessment (02-1609N), which identified strategic points in the reach that would serve to reduce intervention impacts while maximizing results.
The proposed projects for this phase consist of: 1 - Wood complexes to provide refuge, create holding pools, and to add complexity and edge habitat. 2 - Flood fencing at selected locations to increase channel roughness and complexity.
With this suite of projects, we hope to increase edge habitat on the mainstem, reconnect side channels, improve riparian conditions and create pools. River processes are neither being changed nor “improved”, but used to improve habitat, in much the same way that habitat is altered in natural systems. Rather than relying on large-scale interventions, the approach uses the power of the river to affect habitat creation. In this way, long-term benefits can be realized that build upon the foundations laid down by the proposed projects.
|

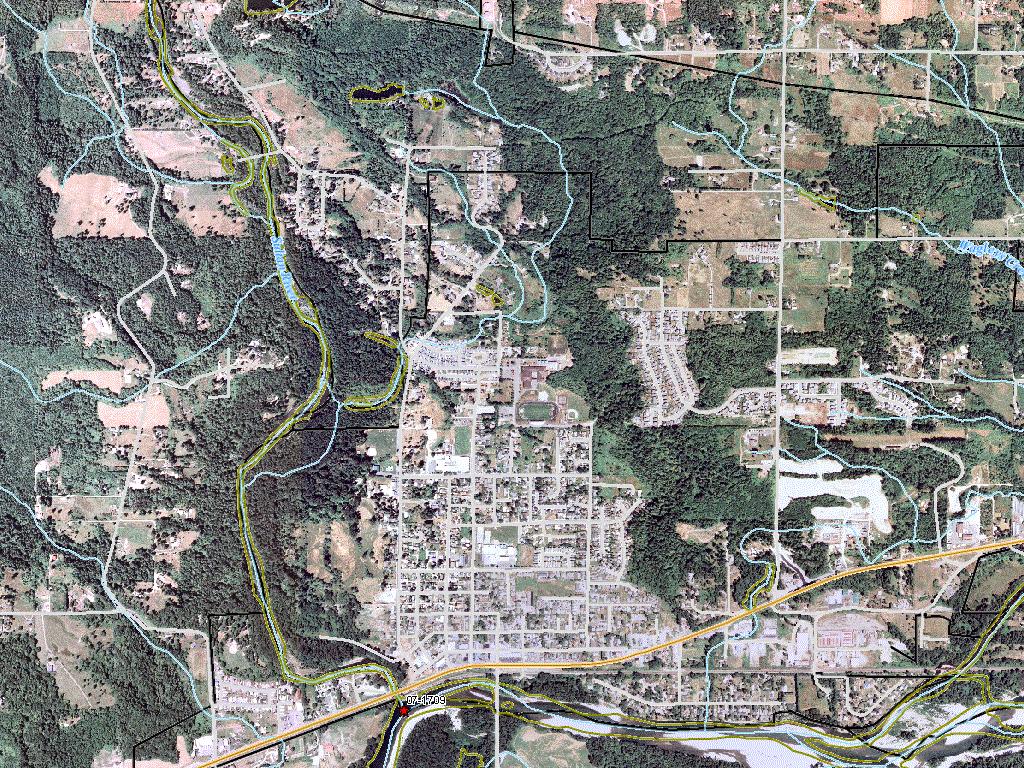

General Area:
|
|
Skykomish Braided Reach
|
Waterbody:
|
|
Skykomish River, Snohomish River, Sultan River
|
County:
|
|
Snohomish
|
Legislative District:
|
|
12
|
Congressional District 2022:
|
|
08
|
Salmon Recovery Regions:
|
|
Puget Sound
|
Watershed Administrative Unit:
|
|
Skykomish River
|
HUC8:
|
|
Skykomish (17110009)
|
WRIA:
|
|
Snohomish
|
Sections:
|
|
05
|
Township:
|
|
T27NR08E
|
Coordinates:
|
|
47.86004513 -121.82033153
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Braided Reach Restoration Phase II (#1)
|
Architectural & Engineering (A&E), Channel structure placement (C.4.d.1), Obtain permits
|
$260,280
|
| Total | $260,280 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Braided Reach Restoration Phase II (#1)
|
|
Property 1 - Sky Braided Reach
|
Private
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Instream Habitat Project |
Channel structure placement (C.4.d.1) |
|
Miles of Stream Treated for channel structure placement (C.4.d.3)
|
3.50
|
|
Acres Of Streambed Treated for channel structure placement (C.4.d.4)
|
5.0
|
|
Number of structures placed in channel (C.4.d.7)
|
18
|
Permits |
Obtain permits |
|
Number of permits required for implementation of project
|
7
|
Milestone Name | Target Date | Description |
Project Start
|
01/01/2008
|
|
Annual Project Billing Due
|
07/31/2008
|
and at least once per year thereafter
|
Special Conditions Met
|
07/31/2009
|
Compliance with Governor’s Executive Order 05-05 has been met according to Dept of Archeology and Historic Preservation letter dated Jan 29, 2008.
|
Annual Project Billing Due
|
07/31/2009
|
|
Applied for Permits
|
09/30/2009
|
Permitting completed in Phase 1
|
A&E Plans Submitted
|
05/15/2010
|
Draft plans
|
Annual Project Billing Due
|
07/31/2010
|
|
Construction Started
|
08/31/2010
|
in conjunction with Phase 1
|
Annual Project Billing Due
|
07/31/2011
|
|
Construction Complete
|
09/30/2011
|
|
Monitor/Steward Plan Submitted
|
12/31/2011
|
|
Proposed Completion Date
|
12/31/2011
|
many projects over large area
|
Progress Report Due
|
01/31/2012
|
|
RCO Final Inspection
|
02/15/2012
|
|
Landowner Agreement to RCO
|
02/29/2012
|
|
Agreement End Date
|
06/15/2012
|
|
Monitoring Complete
|
06/15/2012
|
|
Final Docs/Billing to Mgmt Agy
|
06/30/2012
|
|
