Strawberry Plant Restoration Construction 2008
|
Bainbridge Island City of; Strawberry Plant Restoration Construction 2008 (#08-1971)
Attachment #78738, Strawberry Plant Before
|
|
|
    Funding |
  |
|
    Links |
  |
|
|
The Strawberry Plant property is one of the most significant opportunities to restore lost habitat in Eagle Harbor and will benefit salmon, other fish, shellfish, birds, and other wildlife. The property will eventual be used as a park. Eagle Harbor has suffered significant habitat impacts, including the historic filling of two fairly large subestuary marsh/lagoon habitats in the outer harbor that can never be restored due to Superfund reclamation. The site is located near a recently restored salmon stream (almost 1 mile of habitat opened to chum, cutthroat, coho), 7 small stream subestuaries, 7 recently completed or in-progress nearshore restoration projects, and an aquatic conservancy area (see nearby habitat map). The project is currently under design (SRFB #06-2300N), will undergo permitting in 2008, and construction is planned in 2009. The overall project will restore approximately 1.5 acres of stream mouth, intertidal, and fringe marsh habitat as well as 0.5 acres of riparian habitat. The project includes the following objectives: Remove 95 piles (mostly creosote treated wood); Remove a float that grounds at low tide; Remove 250 feet of shoreline armoring; Remove 23,000 square feet (~3,360 cubic yards) of intertidal/estuarine fill and regrade; Remove concrete, brick, and other debris spread throughout the intertidal zone and stream mouth subestuary; Remove 23,500 square feet of concrete, regrade, amend soil, and replant; and Utilize natural seed recruitment from adjacent native marsh.
|
General Area:
|
|

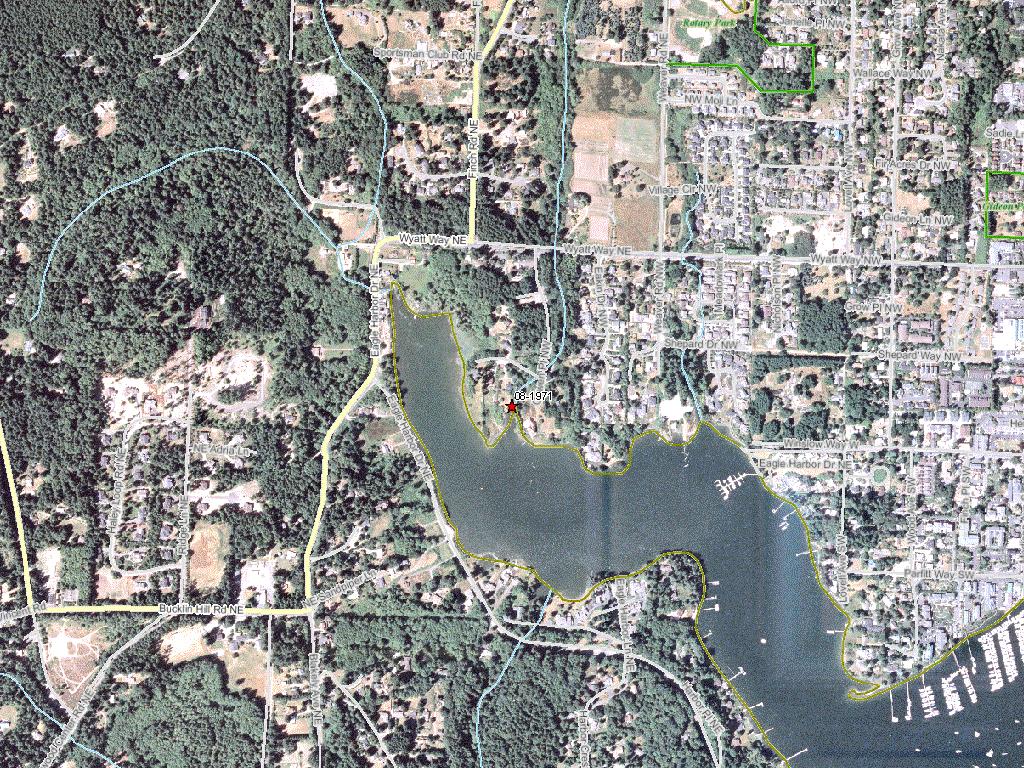

Strawberry Point, Eagle Harbor, Bainbridge Island, Kitsap County
|
Waterbody:
|
|
Puget Sound
|
County:
|
|
Kitsap
|
Legislative District:
|
|
23
|
Congressional District 2022:
|
|
06
|
Salmon Recovery Regions:
|
|
Puget Sound
|
Watershed Administrative Unit:
|
|
Bainbridge Island
|
HUC8:
|
|
Puget Sound (17110019)
|
WRIA:
|
|
Kitsap
|
Sections:
|
|
27
|
Township:
|
|
T25NR02E
|
Coordinates:
|
|
47.62560959 -122.53581781
|
|
|
Worksite Name | Scope of Work | Actual Restoration Cost |
Strawberry Plant (#1)
|
Architectural & Engineering (A&E), Beach nourishment (C.9.l.1), Creation of new estuarine area (C.9.q.1), Debris removal (C.9.n.1), Estuarine plant removal / control (C.9.j.1), Exclusion devices (C.9.p.1), Regrading of slope (C.9.i.1), Road drainage system improvements and reconstruction (C.6.c.1), Shoreline armor removal or modification (C.9.k.1)
|
$672,997
|
| Total | $672,997 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Strawberry Plant (#1)
|
|
Property 1 - Strawberry Plant
|
Local Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Final |
Restoration Metrics (rolled up from Worksite level) |
Estuarine / Nearshore Project |
Regrading of slope (C.9.i.1) |
|
Acres of Estuary Treated through slope regrading (C.9.i.2)
|
0.5
|
Estuarine plant removal / control (C.9.j.1) |
|
Acres of Estuary Treated for plant removal/control (C.9.j.3)
|
2.0
|
Shoreline armor removal or modification (C.9.k.1) |
|
Miles of Shoreline Treated for armor modification/removal (C.9.k.2)
|
0.10
|
|
Acres of Shoreline Treated for armor modification/removal (C.9.k.3)
|
1.0
|
Beach nourishment (C.9.l.1) |
|
Cubic Yards Of Beach Substrate Placed (C.9.l.2)
|
132
|
|
Miles of Shoreline Treated for beach nourishment (C.9.l.3)
|
0.04
|
|
Acres Treated for beach nourishment (C.9.l.4)
|
0.6
|
Debris removal (C.9.n.1) |
|
Acres Treated for debris removal (C.9.n.2)
|
1.2
|
Exclusion devices (C.9.p.1) |
|
Acres Treated with exclusion devices (C.9.p.2)
|
0.1
|
Creation of new estuarine area (C.9.q.1) |
|
Acres of Estuary Created (C.9.q.2)
|
0.4
|
Milestone Name | Target Date | Description |
Project Start
|
12/12/2008
|
|
Annual Project Billing Due
|
07/31/2009
|
Project held up due to public meetings and citizen opposition.
|
Applied for Permits
|
03/15/2010
|
|
Special Conditions Met
|
04/01/2010
|
|
A&E Plans Submitted
|
05/01/2010
|
|
Bid Awarded/Consultant Hired
|
05/01/2010
|
|
RFP Complete
|
05/31/2010
|
|
Construction Started
|
07/15/2010
|
|
Annual Project Billing Due
|
07/31/2010
|
|
Construction Complete
|
11/30/2010
|
|
Monitor/Steward Plan Submitted
|
12/01/2010
|
|
Agreement End Date
|
12/31/2010
|
|
Final Docs/Billing to Mgmt Agy
|
03/01/2011
|
|
