Project Snapshot
PRISM Project #10-1898 (Completed)
Carpenter Creek Estuary Restoration
    Project Details
Kitsap County Comm Development; Carpenter Creek Estuary Restoration (#10-1898)

05/06/2002, Attachment #103842, Carpenter Creek restoration site showing scour holes
Kitsap County Comm Development; Carpenter Creek Estuary Restoration (#10-1898) 05/06/2002, Attachment #103842, Carpenter Creek restoration site showing scour holes

Kitsap County Comm Development; Carpenter Creek Estuary Restoration (#10-1898)

05/06/2002, Attachment #103842, Carpenter Creek restoration site showing scour holes Kitsap County Comm Development; Carpenter Creek Estuary Restoration (#10-1898)

Attachment #103841, Carpenter Creek location near KingstonKitsap County Comm Development; Carpenter Creek Estuary Restoration (#10-1898)

Attachment #103843, map of Carpenter location
Project Status:  Closed Completed since 01/02/2013

Project Type:  Restoration
Project Sponsor:  Kitsap County Community Development
Funding Board:  Salmon Recovery Funding Board
              Funding
Salmon State Projects: $2,301,340
Total RCO Grant: $2,301,340 (100%)
Total Agreement: $2,301,340 (100%)
              Links


    Project Description
This project will restore over 30 acres of undeveloped habitat of the Carpenter Creek estuary, near Kingston, by removal of a tidal-restricting, undersized culvert at South Kingston Road.
The project will increase natural tidal hydrologic fluctuations (inundation and frequency) in sufficient quantities to restore and enhance the following functional ecosystem processes and habitats:
Intertidal mudflats and salt marsh habitat (estuarine reclamation through culvert and fill removal)
Nearshore sediment delivery and transport (consistent and lasting sediment supply, spawning substrate, beach nourishment)
Barrier-free fish passage (Carpenter Creek is a key Puget Sound sub estuary for spawning habitat and for juvenile salmonid smolt outmigration to the Pacific Ocean)
Eelgrass and microalgae beds (refuge from predation and nursery areas for important Puget Sound fin fish and food webs for invertebrate species)
Marine riparian and tidal-freshwater forests (fish and wildlife habitat, pollution control, microclimate, water quality anti-degradation, soil stability and erosion control, nutrient, detrital, macroinvertebrate and other terrestrial inputs)
Reduction of watershed/estuary/shoreline fragmentation (habitat benefits to Puget Sound Chinook, steelhead trout, and other important and/or listed fish species - coho, chum, sea-run cutthroat)
Protection of prey base, salmon feeding areas for state and federally endangered Orca Whales

    Project Contacts

Project Sponsor: Kitsap County Community Development Lead Entity: West Sound Partners for Ecosystem Recovery
  Project Contact: Patty Charnas
pcharnas@co.jefferson.wa.us
(360) 379-4493


Funding Agency: Recreation and Conservation Office
  Project Manager: Josh Lambert
Josh.Lambert@rco.wa.gov
(360) 867-8781


    Project Location

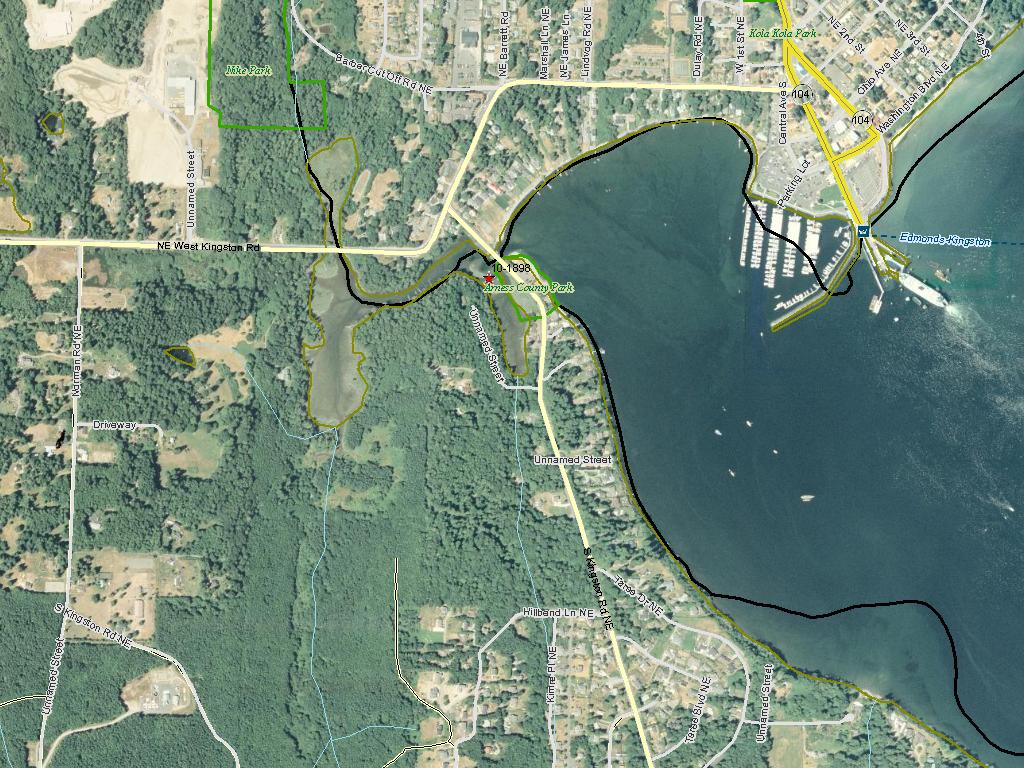

General Area:   carpenter creek
County:   Kitsap
Legislative District:   23
Congressional District 2022:   06
Salmon Recovery Regions:   Puget Sound
Watershed Administrative Unit:   Liberty-Miller-Appletree
HUC8:   Puget Sound (17110019)
WRIA:   Kitsap
Coordinates:   47.79440215
-122.50741647

    Worksites
Worksite NameScope of WorkActual Restoration Cost
Tide gate/culvert at So. Kingston Road, (#1) Architectural & Engineering (A&E), Bridge installed or improved (C.2.g.1), Channel modification (C.9.c.1), Implementation monitoring, Obtain permits, Removal of existing fill material (C.9.g.1), Traffic control, Utility relocation / reconnection $2,301,340
 Total$2,301,340
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Tide gate/culvert at So. Kingston Road, (#1)   Property 1 - South Kingston Carpenter culvert Local Government
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricFinal

Restoration Metrics (rolled up from Worksite level)

Estuarine / Nearshore Project
      Channel modification (C.9.c.1)
Yards (linear measure) of Channel Modified/Created (C.9.c.2) 2958
Acres of Estuary Treated (C.9.c.3) 30.0
      Removal of existing fill material (C.9.g.1)
Acres of Estuary Treated through fill material removal (C.9.g.2) 0.1

Permits
      Obtain permits
Number of permits required for implementation of project 3

Fish Passage Improvement
      Bridge installed or improved (C.2.g.1)
Miles of stream made accessible by bridge installation/repair (C.2.g.3) 10.00
Number of bridges (C.2.g.2) 1

Number of blockages / impediments / barriers impeding passage (C.2.b.4) 1

    Project Milestones
Milestone NameTarget DateDescription
Project Start 08/30/2010
Applied for Permits 12/01/2010
A&E Plans Submitted 12/01/2010
Cultural Resources Complete 12/01/2010
Progress Report Due 01/14/2011
Bid Awarded/Consultant Hired 03/01/2011
Construction Started 06/01/2011
Annual Project Billing Due 07/31/2011
Construction Complete 02/29/2012
Agreement End Date 03/31/2012 May need an extension, spoke with Kathy on 05/03/11
Final Docs/Billing to Mgmt Agy 05/31/2012


    Project Attachments
Attachment TypeAttachment TitleAttach Date
Agreement - State Agreement.pdf 10/01/2010
Correspondence 0 Kitsap Co Parks letter.pdf 09/05/2013
Correspondence Section 7 consultation.pdf 08/05/2010
Correspondence USFWS letter.pdf 08/05/2010
Correspondence water quality certification.pdf 08/05/2010
Correspondence DOE certification letter.pdf 08/05/2010
Cost Estimate engineers cost estimate detail.xls 08/04/2010
Design document Carpenter Creek Mitigation Plan - January 26 2011.pdf 01/28/2011
Design document engineering plan set.pdf 08/04/2010
Final project report Final Report 01/02/2013.pdf 01/02/2013
Map map of Carpenter location.jpg 08/04/2010
Map Carpenter Creek location near Kingston.jpg 08/04/2010
Monitoring activity This is the monitoring plan. Labeled draft but is the final..pdf 07/13/2011
Photo P1060191.jpg 12/11/2012
Photo P1060188.jpg 12/11/2012
Photo P1060206.jpg 12/11/2012
Photo P1060204.jpg 12/11/2012
Photo P1060203.jpg 12/11/2012
Photo P1060199.jpg 12/11/2012
Photo P1060195.jpg 12/11/2012
Photo P1020891.jpg 12/11/2012
Photo P1020889.jpg 12/11/2012
Photo P1020879.jpg 12/11/2012
Photo Carpenter Creek from google earth 8.20.11.jpg 02/08/2012
Photo Carpenter bridge with old culvert showing.jpg 02/07/2012
Photo after installing stake for data logger.jpg 02/07/2012
Photo Carpenter estuary Jan 2012.jpg 02/07/2012
Photo 7-14-11 Installed 10' CMP.jpg 11/02/2011
Photo 9-20-11 pouring of class4000f conc at pier 1.jpg 11/02/2011
Photo tearing out old culvert.jpg 11/02/2011
Photo new bridge taking shape.jpg 11/02/2011
Photo Carpenter Creek restoration site showing scour holes.jpg 08/04/2010
Progress report Progress Report 03/05/2012.pdf 03/05/2012
Progress report Progress Report 11/04/2011.pdf 11/04/2011
Progress report Progress Report 10/27/2011.pdf 10/27/2011
Progress report Progress Report 04/21/2011.pdf 04/21/2011
Project Support / Concern Documents Carpenter Creek JARPA for Corps - November 25 2009.doc 08/04/2010
Project Support / Concern Documents Carpenter Creek HPA.pdf 08/04/2010
Project Support / Concern Documents Carpenter Feasibility EA.pdf 07/12/2010
Project Support / Concern Documents Carpenter Creek Project Narrative.pdf 07/12/2010

Back to top Date of last change: 05/16/2024
