PRISM Project #18-2614 (In Progress)
Berwick Creek Flood Reduction and Restoration
    Project Details

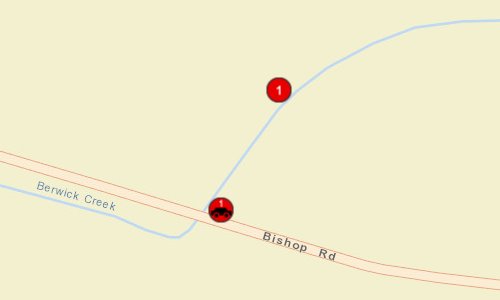

Chehalis Port of; Berwick Creek Flood Reduction and Restoration (#18-2614)

Attachment #386832, ChehalisPhoto.jpg
Chehalis Port of; Berwick Creek Flood Reduction and Restoration (#18-2614) Attachment #386832, ChehalisPhoto.jpg

Chehalis Port of; Berwick Creek Flood Reduction and Restoration (#18-2614)

Attachment #386832, ChehalisPhoto.jpg
Project Status:  Active since 04/17/2019
Planned Completion:  06/30/2025
This project is in progress. Project scope, activities, and dollars may change.

Project Type:  Planning & Development
Project Sponsor:  Port of Chehalis
Funding Board:  Recreation and Conservation Office
              Funding
CBS Flood: $493,172
Total RCO Grant: $493,172 (100%)
Total Agreement: $493,172 (100%)
              RCO Grant Status
Total RCO Grant: $493,172.00
Paid To Date: $333,724.07 (68%)
Grant Balance: $159,447.93 (32%)
              Links


    Project Description
This project will create designs and outreach materials to help restore habitat and stabilize the streambank along a stretch of Berwick Creek in the Chehalis Industrial Park. Additionally, this project was amended to include completion of construction and restoration planting. The two main benefits are restoration and improvement of habitat and flood reduction hazard. This project will increase flood storage capacity and improve in-stream and riparian habitat. The banks are heavily overgrown with invasive Reed Canary Grass which further reduces stream capacity and velocity. This creates bank overflow and flooding of adjacent properties.

    Project Contacts

Project Sponsor: Port of Chehalis Lead Entity: Chehalis Basin Collaborative for Salmon Habitat
  Project Contact: William Teitzel
bteitzel@portofchehalis.com
(360) 880-5411


Funding Agency: Recreation and Conservation Office
  Project Manager: Sasha Medlen
sasha.medlen@rco.wa.gov
(360) 819-3374


    Project Location
County:   Lewis
Legislative District:   20
Congressional District 2022:   03
Sections:   15
Township:   T13NR02W
Coordinates:   46.61927439
-122.91185706

    Worksites
Worksite NameScope of WorkProposed Development and Planning Cost
Berwick Creek Design (2019F-007-DS) (#1) Flood hazard reduction through restoration planning $25,000
Berwick Creek Construction (2019F-007-CS) (#2) Flood hazard reduction through restoration work $89,257
 Total$114,257
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Berwick Creek Design (2019F-007-DS) (#1)   Property 1 - Berwick Creek Local Government
Berwick Creek Construction (2019F-007-CS) (#2)   Property 2 - Berwick Creek Local Government
   Total
Amounts may not be complete

    Project Permits
Permit TypeApplied
Date
Received
Date
Expiration
Date
Permit Number
SEPA 06/14/2019 07/18/2020 UGA-SEP-20-0005
Hydraulics Project Approval [HPA] 05/19/2020 09/22/2022 09/30/2022 2020-5-92+02
Hydraulics Project Approval [HPA] 04/01/2023 05/15/2023 09/21/2025 2020-5-92+02
Building Permit 06/05/2023 09/22/2023 12/10/2024 EM-23-003
Building Permit 07/05/2023 07/18/2023 10/15/2023 RA23-00233

    Project Milestones
Milestone NameTarget DateDescription
Project Start 12/01/2018
Progress Report Due 06/19/2019
Progress Report Due 06/19/2019
Progress Report Due 06/30/2019
Design & Engineering Complete 02/29/2020
Progress Report Due 09/30/2021
Annual Project Billing Due 11/01/2021
Annual Project Billing Due 11/01/2021
Progress Report Due 12/30/2021
Progress Report Due 03/30/2022
Progress Report Due 06/30/2022
Annual Project Billing Due 07/30/2022
Progress Report Due 09/30/2022
Progress Report Due 12/31/2022
Progress Report Due 03/30/2023
Progress Report Due 06/30/2023
Annual Project Billing Due 07/31/2023
Progress Report Due 12/31/2023
Permits Complete 12/31/2023
Construction Complete 12/31/2023
Progress Report Due 06/30/2024
Progress Report Due 12/31/2024
Agreement End Date 06/30/2025
Final Plan to RCO 06/30/2025 As-built describing the construction and installation included in the Year 1 monitoring report and uploaded to PRISM.
Final Report Due 09/30/2025
Final Billing Due 09/30/2025

NOTE: This data is subject to change.

    Project Attachments
Attachment TypeAttachment TitleAttach Date
Agreement - State 18-2614 - Original agreement.pdf 04/08/2019
Agreement attachment Berwick Creek_SilverLake Contract signed.pdf.pdf 12/01/2023
Agreement attachment Berwick Creek Restoration Contract Documents.pdf.pdf 12/01/2023
Amendment - State Amendment #11 - Time Extension.pdf 06/12/2024
Amendment - State Amendment #10 - Cost Change.pdf 06/27/2023
Amendment - State Amendment #9 - Time Extension.pdf 04/18/2023
Amendment - State Amendment #8 - Cost Change.pdf 10/11/2022
Amendment - State Amendment #7 - Cost Change.pdf 02/14/2022
Amendment - State Amendment #5 - Cost Change.pdf 01/05/2022
Amendment - State Amendment #6 - Time Extension.pdf 12/09/2021
Amendment - State Amendment #4 - Cost Change.pdf 06/29/2021
Amendment - State Amendment #3 - Time Extension.pdf 03/09/2021
Amendment - State Amendment #2 - Cost and Scope.pdf 11/14/2019
Amendment - State Amendment #1 - Time Ext.pdf 06/17/2019
Amendment request 18-2614 Amend. 11 Time Ext Request.docx.docx 06/12/2024
Amendment request Amendment #10 Request.docx.docx 07/06/2023
Amendment request Executive Committee -- Projects Committee Recommendartion 4-.pdf 05/10/2023
Amendment request Staff Memo -- Local Project Time Extensions 3-15-2023(3).pdf.pdf 03/31/2023
Amendment request Amendment 9 Request Form.docx.docx 03/31/2023
Applicant Resolution/Authorizations Berwick Landowner Ackn GILLMAN.pdf.pdf 06/21/2023
Application Review Report Application Review Report, 18-2614P(compl 04/16/19 15:36:59).pdf 04/16/2019
Correspondence Cover and application (1).pdf.pdf 06/21/2023
Correspondence Port of Chehalis Mail - FW_ 138790 - FW_ [URL Verdict_ Neutr.pdf 06/21/2023
Correspondence 18-2614 Landowner Ack J_GILLMAN.pdf.pdf 03/24/2023
Cultural Resource Screening Report Berwick Creek report formatted 2023_10_28.pdf.pdf 12/01/2023
Cultural Resource Screening Report Berwick Creek Restoration Project-Arch Eval Rpt 4688.pdf.pdf 06/30/2022
Design document Berwick Plan & Sections.pdf.pdf 02/26/2020
Environmental Site Assessment Report Berwick Creek Pre-App JARPA 19.05.20.pdf.pdf 02/26/2020
Final design Berwick Ck Restoration Permit Planset.pdf.pdf 04/15/2024
Historical - Progress and Final Reports 2023 Berwick Creek Restoration Summary Report.pdf.pdf 12/01/2023
Historical – Compliance Documents DRAFT 2023_02_03 Berwick Creek M&D Plan_revised_3 (1).pdf.pdf 03/22/2023
Historical – Legal Documents 3587814 Quit Claim.pdf.pdf 03/24/2023
Permit 20230608-NWP27-VerifLtr-NWS-2019-745.pdf.pdf 04/15/2024
Permit RA23-00233 Access Letter and Permit.pdf.pdf 12/01/2023
Permit EM-23-003 Issued Permit (1).pdf.pdf 12/01/2023
Permit 20200505-PmtNotif-NWS-2019-745.pdf.pdf 06/21/2023
Permit Modified Berwick Creek Flood Reduction Restoration HPA 21460.pdf 06/21/2023
Permit Hydraulic Project Approval.pdf.pdf 06/30/2022
Photo Photo Feb 21 2024, 11 56 36 AM.jpg.jpg 07/30/2024
Photo Berwick_Tour5.jpg.jpg 07/30/2024
Photo Berwick_Tour4.jpg.jpg 07/30/2024
Photo Berwick_Tour3.jpg.jpg 07/30/2024
Photo Berwick_Tour2.jpg.jpg 07/30/2024
Photo Berwick_Tour1.jpg.jpg 07/30/2024
Photo Berwick Restoration Project photo (58).jpg 12/01/2023
Photo Berwick Restoration Project photo (45).jpg 12/01/2023
Photo Berwick Restoration Project photo (44).jpg 12/01/2023
Photo Berwick Restoration Project photo (43).jpg 12/01/2023
Photo Berwick Restoration Project photo (39).jpg 12/01/2023
Photo Berwick Restoration Project photo (59).jpg 12/01/2023
Photo Berwick Restoration Project photo (57).jpg 12/01/2023
Photo Berwick Restoration Project photo (56).jpg 12/01/2023
Photo Berwick Restoration Project photo (55).jpg 12/01/2023
Photo Berwick Restoration Project photo (54).jpg 12/01/2023
Photo Berwick Restoration Project photo (53).jpg 12/01/2023
Photo Berwick Restoration Project photo (52).jpg 12/01/2023
Photo Berwick Restoration Project photo (51).jpg 12/01/2023
Photo Berwick Restoration Project photo (50).jpg 12/01/2023
Photo Berwick Restoration Project photo (49).jpg 12/01/2023
Photo Berwick Restoration Project photo (48).jpg 12/01/2023
Photo Berwick Restoration Project photo (47).jpg 12/01/2023
Photo Berwick Restoration Project photo (46).jpg 12/01/2023
Photo Berwick Restoration Project photo (42).jpg 12/01/2023
Photo Berwick Restoration Project photo (41).jpg 12/01/2023
Photo Berwick Restoration Project photo (40).jpg 12/01/2023
Photo Berwick Restoration Project photo (38).jpg 12/01/2023
Photo Berwick Restoration Project photo (37).jpg 12/01/2023
Photo Berwick Restoration Project photo (36).jpg 12/01/2023
Photo Berwick Restoration Project photo (35).jpg 12/01/2023
Photo Berwick Restoration Project photo (34).jpg 12/01/2023
Photo Berwick Restoration Project photo (33).jpg 12/01/2023
Photo Berwick Restoration Project photo (32).jpg 12/01/2023
Photo Berwick Restoration Project photo (31).jpg 12/01/2023
Photo Berwick Restoration Project photo (30).jpg 12/01/2023
Photo Berwick Restoration Project photo (29).jpg 12/01/2023
Photo Berwick Restoration Project photo (28).jpg 12/01/2023
Photo Berwick Restoration Project photo (27).jpg 12/01/2023
Photo Berwick Restoration Project photo (26).jpg 12/01/2023
Photo Berwick Restoration Project photo (25).jpg 12/01/2023
Photo Berwick Restoration Project photo (24).jpg 12/01/2023
Photo Berwick Restoration Project photo (23).jpg 12/01/2023
Photo Berwick Restoration Project photo (22).jpg 12/01/2023
Photo Berwick Restoration Project photo (21).jpg 12/01/2023
Photo Berwick Restoration Project photo (20).jpg 12/01/2023
Photo Berwick Restoration Project photo (19).jpg 12/01/2023
Photo Berwick Restoration Project photo (18).jpg 12/01/2023
Photo Berwick Restoration Project photo (17).jpg 12/01/2023
Photo Berwick Restoration Project photo (16).jpg 12/01/2023
Photo Berwick Restoration Project photo (15).jpg 12/01/2023
Photo Berwick Restoration Project photo (14).jpg 12/01/2023
Photo Berwick Restoration Project photo (13).jpg 12/01/2023
Photo Berwick Restoration Project photo (12).jpg 12/01/2023
Photo 1Berwick Restoration Project photo (11).jpg 12/01/2023
Photo Berwick Restoration Project photo (10).jpg 12/01/2023
Photo Berwick Restoration Project photo (9).jpg 12/01/2023
Photo Berwick Restoration Project photo (8).jpg 12/01/2023
Photo Berwick Restoration Project photo (7).jpg 12/01/2023
Photo Berwick Restoration Project photo (6).jpg 12/01/2023
Photo Berwick Restoration Project photo (5).jpg 12/01/2023
Photo Berwick Restoration Project photo (4).jpg 12/01/2023
Photo Berwick Restoration Project photo (3).jpg 12/01/2023
Photo Berwick Restoration Project photo (2).jpg 12/01/2023
Photo Berwick Restoration Project photo (1).jpg 12/01/2023
Photo ChehalisPhoto.jpg.jpg 04/16/2019
Progress report Progress Report, 18-2614 (accepted 12/31/24 08:41:14).pdf 12/31/2024
Progress report Progress Report, 18-2614 (accepted 08/20/24 14:39:29).pdf 08/20/2024
Progress report Progress Report, 18-2614 (accepted 12/11/23 16:08:13).pdf 12/11/2023
Progress report Progress Report, 18-2614 (accepted 07/05/23 14:00:44).pdf 07/05/2023
Progress report Progress Report, 18-2614 (accepted 03/29/23 17:24:57).pdf 03/29/2023
Progress report Progress Report, 18-2614 (accepted 12/21/22 13:47:26).pdf 12/21/2022
Progress report Progress Report, 18-2614 (accepted 09/15/22 09:45:25).pdf 09/15/2022
Progress report Progress Report, 18-2614 (accepted 08/10/22 12:20:50).pdf 08/10/2022
Progress report Progress Report, 18-2614 (accepted 03/30/22 14:11:43).pdf 03/30/2022
Progress report Progress Report, 18-2614 (accepted 01/25/22 09:00:23).pdf 01/25/2022
Progress report Progress Report, 18-2614 (accepted 06/24/19 15:20:23).pdf 06/24/2019
Project Application Report Application Report, 18-2614P (submitted 04/16/19 15:33:42).pdf 04/16/2019
Project Deliverables Photo collate Sept 2024 compressed.pdf.pdf 11/14/2024
Video DJI_0004(2).MOV.mov 12/01/2023
Video DJI_0003.MOV.mov 12/01/2023

Back to top Date of last change: 12/31/2024
