PRISM Project #21-1066 (In Progress)
Hoypus Point Shoreline Restoration Construction
    Project Details
NW Straits Marine Cons Found; Hoypus Point Shoreline Restoration Construction (#21-1066)

Attachment #463002, HoypusPt2
NW Straits Marine Cons Found; Hoypus Point Shoreline Restoration Construction (#21-1066) Attachment #463002, HoypusPt2

NW Straits Marine Cons Found; Hoypus Point Shoreline Restoration Construction (#21-1066)

Attachment #463002, HoypusPt2 NW Straits Marine Cons Found; Hoypus Point Shoreline Restoration Construction (#21-1066)

Attachment #463003, HoypusPt3
Project Status:  Active since 11/22/2021
Planned Completion:  12/31/2025
This project is in progress. Project scope, activities, and dollars may change.

Project Type:  Restoration
Project Sponsor:  Northwest Straits Marine Conservation Foundation
Funding Board:  Salmon Recovery Funding Board
              Funding
ESRP Small Projects: $148,803
Salmon Federal Projects: $155,058
Total RCO Grant: $303,861 (100%)
Sponsor Match: $1,197 (0%)
Total Agreement: $305,058 (100%)
              RCO Grant Status
Total RCO Grant: $303,861.00
Paid To Date: $290,887.53 (96%)
Grant Balance: $12,973.47 (4%)
              Links


    Project Description
Northwest Straits Foundation and project partners propose to remove approximately 350 linear feet of shoreline armor and up to 1/3 acre of fill to re-establish nearshore processes at Hoypus Point, Deception Pass State Park, Whidbey Island. Beach nourishment will be added to supplement forage fish spawning while the habitat forming processes are reestablished following removal. A portion of the existing road will be decommissioned and converted to a gravel trail (trail width to be determined in the upcoming preliminary design phase) and the riparian zone will be replanted with native trees, shrubs, and groundcovers following construction. The site is located along a transport zone within the upper third of the 2.4 mile-long drift cell and the project will restore a bluff-backed beach and the marine riparian connection. The primary species supported by these habitats include ESA listed Chinook salmon, coho, chum, pink, and steelhead as well as spawning habitat for surf smelt and Pacific sand lance.

    Project Contacts

Project Sponsor: Northwest Straits Marine Conservation Foundation Lead Entity: Island County Lead Entity
  Project Contact: Lisa Kaufman
kaufman@nwstraitsfoundation.org
(360) 393-6948


Funding Agency: Recreation and Conservation Office
  Project Manager: Bridget Kaminski
bridget.kaminski@rco.wa.gov
(360) 472-5546

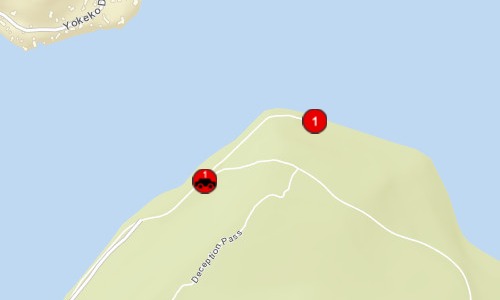

    Project Location
County:   Island
Legislative District:   10
Congressional District 2022:   02
Salmon Recovery Regions:   Puget Sound
Watershed Administrative Unit:   Whidbey Island
HUC8:   Puget Sound (17110019)
WRIA:   Island
Sections:   30
Township:   T34NR02E
Coordinates:   48.41092950
-122.60693412

    Worksites
Worksite NameScope of WorkProposed Restoration Cost
Hoypus Point (#1) Agency Indirect, Architectural & Engineering (A&E), Beach nourishment (C.9.l.1), Cultural resources, Estuarine planting or native plant establishment (C.9.r.1), Removal of existing fill material (C.9.g.1), Shoreline armor removal or modification (C.9.k.1) $305,058
 Total$305,058
Amounts may not be complete

    Properties
Worksite Name Property NameLandowner Type
Hoypus Point (#1)   Property 1 - Deception Pass State Park State Government
   Total
Amounts may not be complete

    Project Metrics (Outcomes, Benefits)
 Category / Work Type / MetricProposed

Restoration Metrics (rolled up from Worksite level)

Estuarine / Nearshore Project
      Removal of existing fill material (C.9.g.1)
Acres of Estuary Treated through fill material removal (C.9.g.2) 0.3
      Shoreline armor removal or modification (C.9.k.1)
Miles of Shoreline Treated for armor modification/removal (C.9.k.2) 0.06
Acres of Shoreline Treated for armor modification/removal (C.9.k.3) 0.5
      Beach nourishment (C.9.l.1)
Miles of Shoreline Treated for beach nourishment (C.9.l.3) 0.01
Acres Treated for beach nourishment (C.9.l.4) 0.1

    Project Permits
Permit TypeApplied
Date
Received
Date
Expiration
Date
Permit Number
Clear & Grade Permit
Shoreline Permit 02/11/2022 04/08/2022 SHE 055.22
SEPA 12/08/2021 01/18/2022
Nationwide Permit 06/15/2021 11/24/2021 NWS-2021-631
Hydraulics Project Approval [HPA] 12/29/2021 03/18/2022 03/17/2027 2022-4-177+01
Endangered Species Act Compliance [ESA] 08/24/2021
Cultural Assessment [Section 106] 09/27/2021
Aquatic Lands Use Authorization

    Project Milestones
Milestone NameTarget DateDescription
Project Start 07/01/2021
Applied for Permits 07/01/2021
Cultural Resources Complete 02/28/2022 Federal Nexus: Based upon your grant application this project appears to be subject to Section 106 of the NHPA. Sponsor must provide evidence of S106 compliance (Corps of Engineers permit). See special condition #1.
Final Design to RCO 04/01/2022 Attach to PRISM: Final engineering design report, drawings, and cost estimate; Construction Specifications
Progress Report Due 04/15/2022
Bid Awarded/Contractor Hired 06/30/2022
Other 06/30/2022 Attach copy of advertisement, bid results, construction contract to PRISM
Annual Project Billing Due 07/31/2022
Landowner Agreement to RCO 09/01/2022
Restoration Started 10/01/2022 construction
Permits Complete 10/06/2022
Progress Report Due 10/15/2022
Other 12/31/2022 Attach Communication Plan to PRISM. NWSF, Island County Marine Resources Committee, Island Co Dept of Natural Resources, and WA State Parks will develop a communication plan identifying stakeholders and planned outreach to media and park users.
Funding Acknowl Sign Posted 02/15/2023
Restoration Complete 02/15/2023 construction
Restoration Started 02/15/2023 planting
Progress Report Due 04/15/2023
Final Design to RCO 04/15/2023 As-built documentation attached in PRISM If completed project differs from final design (include an explanation if the constructed project differs significantly from the final design)
Annual Project Billing Due 07/31/2023
Progress Report Due 10/15/2023
Progress Report Due 04/15/2024
Annual Project Billing Due 07/31/2024
Progress Report Due 10/15/2024
Progress Report Due 04/15/2025
RCO Final Inspection 04/30/2025
Special Conditions Met 06/30/2025 Ensure compliance with scope of work
Progress Report Due 10/15/2025
Restoration Complete 11/30/2025 planting
Agreement End Date 12/31/2025 PROJECT CLOSING. All expenditures must be prior to this date.
Final Billing Due 02/27/2026
Final Report Due 02/28/2026

NOTE: This data is subject to change.

    Project Attachments
Attachment TypeAttachment TitleAttach Date
Agreement - State 21-1066 Agreement - Hoypus Point Shoreline Restoration Const.pdf 11/22/2021
Amendment - State 21-1066 Amendment #1 - Time Extension.pdf 12/31/2024
Amendment request 21-1066 esrp approval of time ext 121324.docx 12/13/2024
Amendment request ESRP-AmendRequest_20-1066_20241212.docx 12/12/2024
Applicant Resolution/Authorizations Applicant-Authorization-Resolution (Don Hunger).docx.docx 02/15/2021
Application Document HoypusPt_NWSF_21-1066_Mar2021.pdf.pdf 03/30/2021
Application Review Report Grant Manager Comments, 21-1066R(compl 07/18/21 19:31).pdf 07/18/2021
Application Review Report Grant Manager Comments, 21-1066R(rtnd 03/30/21 08:39).pdf 03/30/2021
Communication Plan Hoypus Point_Communications&Outreach Plan_APR2023.docx.docx 04/14/2023
Communication Plan Hoypus Point_Communications&Outreach Plan_Feb2023.docx.docx 03/03/2023
Cost Estimate SAL-CostEstimate_21-1066.xlsx.xlsx 02/15/2021
Cultural Resource Screening Report Project Cultural Resource Screening Report (11/22/21 10:44:5.pdf 11/22/2021
Cultural Resource Screening Report Project Cultural Resource Screening Report (10/25/21 10:37:0.pdf 10/25/2021
Cultural Resource Screening Report Project Cultural Resource Screening Report (10/19/21 17:17:5.pdf 10/19/2021
Design document Hoypus Point Final Design Report w_App April 2022.pdf.pdf 07/01/2022
Design document Hoypus Point Geotechnical Evaluation Revised Final_20210405.pdf 06/17/2021
Design document HOYPUS_90Per_DESIGN-23APR2021-Draft.pdf.pdf 05/10/2021
Design document BCE_WE Conceptual Design _ Hoypus Point with Attachments 033.pdf 03/31/2021
Design document (as built) HOYPUS_RECORDDRAWINGS_1Mar2023 (002).pdf.pdf 04/14/2023
Map: Area of Potential Effect (APE) Project APE Report (11/22/21 10:44:55).pdf 11/22/2021
Map: Area of Potential Effect (APE) Project APE Report (10/25/21 10:37:03).pdf 10/25/2021
Map: Area of Potential Effect (APE) Project APE Report (10/19/21 17:17:25).pdf 10/19/2021
Map: Area of Potential Effect (APE) HoypusPt_APE.pdf.pdf 02/15/2021
Map: Restoration Worksite 21-1066_HP_RESTORATIONPLAN.pdf.pdf 02/15/2021
Permit HOYPUS POINT_PERMITS.pdf.pdf 04/04/2022
Permit ESA COMPLIANCE_COMPLETED.pdf.pdf 04/04/2022
Permit 20210615-JARPA.pdf.pdf 06/17/2021
Permit 20210615-AbbrevBE.pdf.pdf 06/17/2021
Permit 20210614-LIMIT8FORM-PERMIT APPLICATION.pdf.pdf 06/17/2021
Photo ORD 2024_Hoypus (10).JPG.jpg 11/01/2024
Photo ORD 2024_Hoypus (9).JPG.jpg 11/01/2024
Photo ORD 2024_Hoypus (2).JPG.jpg 11/01/2024
Photo 20240410_SpringPlanting_LBK (3).JPG.jpg 04/11/2024
Photo 20240410_SpringPlanting_LBK (2).JPG.jpg 04/11/2024
Photo ORD 2023_KZupich (21).jpg.jpg 11/14/2023
Photo ORD 2023_KZupich (13).jpg.jpg 11/14/2023
Photo HP_20221103_Friesen (5).jpeg.jpeg 04/14/2023
Photo HP_20221103_End of Trail_PreCompaction_Friesen.jpeg.jpeg 04/14/2023
Photo HOYPUS_CONSTRUCTION 20221026 (15).jpg.jpg 04/14/2023
Photo HOYPUS_CONSTRUCTION 20221026 (5).jpg.jpg 04/14/2023
Photo HOYPUS_CONSTRUCTION 20221026 (3).jpg.jpg 04/14/2023
Photo 20230124_KINGTIDE (10).JPG.jpg 04/14/2023
Photo PUCCI_DRONE_W-E1-POST CONSTR 20221108.JPG.jpg 04/14/2023
Photo PUCCI_DRONE_OVERHEAD2-POST CONSTR 20221108.JPG.jpg 04/14/2023
Photo PUCCI_DRONE_OVERHEAD1-POST CONST 20221108.JPG.jpg 04/14/2023
Photo PUCCI_DRONE_PRE-CONSTRUCTION.JPG.jpg 04/14/2023
Photo HP_Armor Rock_West to East_Zeke.JPG.jpg 11/12/2022
Photo HP_End of Trail_PRE.JPG.jpg 11/12/2022
Photo HP_20221103_West to East_Friesen.jpeg.jpeg 11/12/2022
Photo HP_End of Trail_20221103_Friesen (4).jpeg.jpeg 11/12/2022
Photo HoypusPt3.jpg 02/15/2021
Photo HoypusPt2.jpg 02/15/2021
Photo HoypusPt1.jpg 02/15/2021
Plans and Bid Specifications Hoypus Point_Specs_100%_20220314_FINAL.pdf.pdf 07/01/2022
Progress report Progress Report, 21-1066 (accepted 11/13/24 15:17:54).pdf 11/13/2024
Progress report Progress Report, 21-1066 (accepted 04/29/24 11:30:47).pdf 04/29/2024
Progress report Progress Report, 21-1066 (accepted 11/16/23 11:17:25).pdf 11/16/2023
Progress report Progress Report, 21-1066 (accepted 04/26/23 10:06:21).pdf 04/26/2023
Progress report Progress Report, 21-1066 (accepted 10/24/22 14:35:08).pdf 10/24/2022
Progress report Progress Report, 21-1066 (accepted 04/12/22 09:25:56).pdf 04/12/2022
Project Application Report Project Application Report, 21-1066R (sub 10/25/21 10:36:56).pdf 10/25/2021
Project Application Report Project Application Report, 21-1066R (sub 10/11/21 12:08:20).pdf 10/11/2021
Project Application Report Project Application Report, 21-1066R (sub 06/17/21 10:33:13).pdf 06/17/2021
Project Application Report Project Application Report, 21-1066R (sub 02/15/21 21:50:57).pdf 02/15/2021
Project Review Comments Proj Review Comments Final, 21-1066R(compl 10/25/21 10:35).pdf 10/25/2021
Project Review Comments Proj Review Comments LE, 21-1066R(compl 10/25/21 10:35).pdf 10/25/2021
Project Review Comments Proj Review Comments Initial, 21-1066R(compl 10/25/21 10:35).pdf 10/25/2021
Project Review Comments Proj Review Comments Final, 21-1066R(compl 10/11/21 12:06).pdf 10/11/2021
Project Review Comments Proj Review Comments LE, 21-1066R(compl 10/11/21 12:06).pdf 10/11/2021
Project Review Comments Proj Review Comments Initial, 21-1066R(compl 10/11/21 12:06).pdf 10/11/2021
Scope of work 21-1066 Statement of Work 10-22-21.docx 10/22/2021
Visuals Hoypus Restoration Panel_draft layout v4.pdf.pdf 04/11/2024
Visuals Hoypus Ferry Panel_draft layout v4.pdf.pdf 04/11/2024
Visuals CONSTRUCTION NOTIFICATION SIGN.pdf.pdf 10/14/2022

Back to top Date of last change: 01/02/2025
