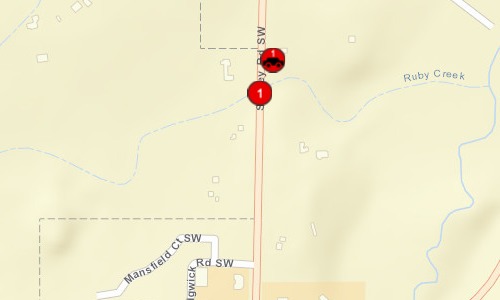

Ruby Creek Culvert at Sidney Rd Port Orchard
|
Project Status:  |
Approved-Pending Budget since 12/05/2024 |
Planned Completion: |
04/30/2028
|
Project Type:  |
Restoration |
  |
|
Funding Board:  |
Recreation and Conservation Office
|
    Funding |
  |
|
    Links |
  |
|
|
The City of Port Orchard will use this grant to fund the removal of the Ruby Creek Barrier at Sidney Rd. to improve fish passage within the creek. The barrier is located on Sidney Rd. approximately 3000 ft north of the intersection of Sedgwick Rd. and Sidney Rd. (-122.65304 x 47.50117). This is the lowest and most significant barrier on Ruby Creek before it merges with Blackjack Creek, substantially blocking fish migration from Blackjack upstream to Ruby. Funding this project will help to restore stream connectivity between Ruby Creek and Blackjack Creek, improving passage of populations of Endangered Species Act listed East Kitsap DIP Steelhead, Coho, Chinook, Chum and Cutthroat that are present in both streams. The primary habitat that will be restored is in-stream habitat and riparian habitat creating accessibility for fish to approximately 1,102 square meters of spawning habitat and 44,382 square meters of rearing habitat. This culvert has been rated by WDFW with a PI total of 37.86. This barrier removal will improve habitat connectivity and increase fecundity of existing fish populations by removing barriers and restoring natural vegetation and processes to Ruby Creek, promoting angling and wildlife viewing opportunities. Several other barrier removals have been conducted or are scheduled upstream and downstream of the Sidney Rd. barrier, leaving this culvert the last limiting barrier for fish migration on Ruby Creek. Removing this barrier opens 0.81 miles of stream.
|
General Area:
|
|
Kitsap County
|
County:
|
|
Kitsap
|
Legislative District:
|
|
26
|
Congressional District 2022:
|
|
06
|
Salmon Recovery Regions:
|
|
Puget Sound
|
Watershed Administrative Unit:
|
|
S Sinclair Inlet
|
HUC8:
|
|
Puget Sound (17110019)
|
WRIA:
|
|
Kitsap
|
Sections:
|
|
11
|
Township:
|
|
T23NR01E
|
Coordinates:
|
|
47.50122900 -122.65293605
|
|
|
Worksite Name | Scope of Work | Proposed Restoration Cost |
Ruby Creek Culvert at Sidney Rd. (#1)
|
Architectural & Engineering (A&E), Cultural resources, Culvert installed or improved (C.2.f.1), Obtain permits
|
$2,179,815
|
| Total | $2,179,815 |
Amounts may not be complete
Worksite Name | | Property Name | Landowner Type |
Ruby Creek Culvert at Sidney Rd. (#1)
|
|
Property 1 - Sidney Rd. culvert
|
Local Government
|
| | | Total |
Amounts may not be complete
| Category / Work Type / Metric | Estimated |
Restoration Metrics (rolled up from Worksite level) |
Fish Passage Improvement |
Culvert installed or improved (C.2.f.1) |
|
Miles of stream made accessible by culvert installation/repair (C.2.f.3)
|
5.50
|
|
Number of culverts (C.2.f.2)
|
1
|
|
|
Number of blockages / impediments / barriers impeding passage (C.2.b.4)
|
1
|
Permit Type | Applied Date | Received Date | Expiration Date | Permit Number |
SEPA
|
|
|
|
|
Building Permit
|
|
|
|
|
Cultural Assessment [Section 106]
|
|
|
|
|
Hydraulics Project Approval [HPA]
|
|
|
|
|
Other Required Permits
|
|
|
|
|
Clear & Grade Permit
|
|
|
|
|
Other Required Permits
|
|
|
|
|
Milestone Name | Target Date | Description |
Project Start
|
01/15/2025
|
|
Bid Awarded/Contractor Hired
|
05/01/2025
|
RFP design consultant hired
|
Annual Project Billing Due
|
06/30/2025
|
|
Progress Report Due
|
06/30/2025
|
|
Special Conditions Met
|
06/30/2025
|
TRT review of conceptual designs submitted at application complete
|
Annual Project Billing Due
|
12/31/2025
|
|
Progress Report Due
|
12/31/2025
|
|
Preliminary Design to RCO
|
05/01/2026
|
Submit to RCO and TRT
|
Applied for Permits
|
06/01/2026
|
|
Special Conditions Met
|
06/30/2026
|
TRT review of preliminary designs complete
|
Progress Report Due
|
06/30/2026
|
|
Cultural Resources Complete
|
07/30/2026
|
See special conditions
|
Final Design to RCO
|
09/30/2026
|
Submit to RCO and TRT
|
Special Conditions Met
|
11/30/2026
|
TRT review of final designs complete
|
Annual Project Billing Due
|
12/31/2026
|
|
Progress Report Due
|
12/31/2026
|
|
Permits Complete
|
02/01/2027
|
|
Bid Awarded/Contractor Hired
|
05/14/2027
|
Construction contractor
|
Funding Acknowl Sign Posted
|
06/30/2027
|
|
Progress Report Due
|
06/30/2027
|
|
Restoration Started
|
07/15/2027
|
|
Restoration Complete
|
11/30/2027
|
|
Annual Project Billing Due
|
12/31/2027
|
|
Progress Report Due
|
12/31/2027
|
|
RCO Final Inspection
|
03/01/2028
|
|
Stewardship Plan to RCO
|
03/31/2028
|
|
Other
|
03/31/2028
|
As-built drawings and or report as necessary
|
Final Report Due
|
04/30/2028
|
Up to 90 days from Agreement End
|
Agreement End Date
|
04/30/2028
|
|
Final Billing Due
|
04/30/2028
|
Up to 90 days from Agreement End
|
NOTE: This data is subject to change.
